Impact of Increased Scrutiny of High Value High Risk Projects
Overview
The government adopted the High Value High Risk (HVHR) process in late 2010 because of past cost overruns of over $2 billion attributed to inadequate management of project business cases and procurements. The process covers all public sector infrastructure and information and communications technology investments that are likely to draw on Budget funding and are over $100 million or assessed as high risk.
The goal of the HVHR process is to achieve more certainty in the delivery of intended benefits, in line with planned costs and time lines, through extra scrutiny by the Department of Treasury and Finance (DTF), together with additional Treasurer's approvals at key milestones covering the business case, procurement and monitoring after the procurement decision.
DTF's increased scrutiny through the HVHR process has made a difference to the quality of the business cases and procurements underpinning government's infrastructure investments. However, these improvements have not lifted practices so that they consistently and comprehensively meet DTF's better practice guidelines. This means government is still exposed to the risk that projects fail to deliver intended benefits on time and within approved budgets. A robust HVHR process is critical to effectively managing this risk.
DTF's scrutiny of HVHR projects was best in relation to project costs, time lines and agencies' approaches to risk management. The quality of scrutiny applied was more mixed for procurement, governance and project management and clearly inadequate when providing assurance about the expected project benefits. None of the business cases examined in the audit adequately justified the benefits of the respective projects.
The audit identified gaps and inconsistencies in DTF's approach to identifying projects to be subject to HVHR review, and the need for improved management of the process. In addition, DTF is yet to evaluate the impacts of the HVHR process on project outcomes.
The VicRoads RandL registration and licensing system project is the type of complex project that HVHR is meant to deal with and an example where significant negative deliverability risks have materialised. While the project commenced well before the HVHR process was introduced, it has been monitored through HVHR since late 2011. The government has now paused the project until February 2015. RandL is currently running at least 18 months late, has cost around $102 million and VicRoads has proposed additional expenditure of up to $135 million more than the approved budget of $158 million.
Impact of Increased Scrutiny of High Value High Risk Projects: Message
Ordered to be printed
VICTORIAN GOVERNMENT PRINTER June 2014
PP No 333, Session 2010–14
President
Legislative Council
Parliament House
Melbourne
Speaker
Legislative Assembly
Parliament House
Melbourne
Dear Presiding Officers
Under the provisions of section 16AB of the Audit Act 1994, I transmit my report on the audit Impact of Increased Scrutiny of High Value High Risk Projects.
The audit assessed the effectiveness of the High Value, High Risk (HVHR) process in improving project business cases and procurements so that they provide an adequate basis for delivering intended project benefits within approved time lines and cost.
I found that the Department of Treasury and Finance's (DTF) increased scrutiny of High Value High Risk projects has made a difference to the quality of the business cases and procurements underpinning government's infrastructure investments. However, these improvements have not lifted practices so that they consistently and comprehensively meet DTF's better practice guidelines.
This means government is still exposed to the risk that projects fail to deliver intended benefits on time and within approved budgets. This risk is most significant in DTF's assessment of the deliverability of projects' benefits where its scrutiny is clearly inadequate.
I have made eight recommendations aimed at improving the coverage, rigour of scrutiny, management and evaluation of the HVHR process.
Yours faithfully
John Doyle
Auditor-General
26 June 2014
Auditor-General's comments
John Doyle Auditor-General |
Audit team Ray Winn—Sector Director Tony Brown—Team Leader Michelle Tolliday—Manager Sid Nair—Analyst Paul O'Connor—Engagement Quality Control Reviewer |
Parliament and the community rightly expect that publicly-funded capital investments are planned and managed in a way that delivers predicted benefits on time and within allocated budgets.
It is critical that government is fully and reliably informed about projects' costs and benefits, and the risks affecting these before deciding what to do. The consequences of failing to do this, especially for high value projects, are significant—unexpected cost blow-outs affect the government's ability to deliver its wider policy agenda, unforeseen delays mean the community has to wait longer for promised benefits, and unreliable benefit estimates risk distorting government's decision-making.
VAGO's publication Reflections on audits 2006–2012: Lessons from the past, challenges for the future identified poor business case development, including gaps in the information underpinning decisions, and the inadequate consideration of available procurement options as recurring shortcomings.
The government introduced the High Value High Risk (HVHR) process to more rigorously review business cases and procurements to provide it with more certainty that claimed benefits could be delivered within the time lines and costs estimated by proponents.
I am pleased that government has recognised this gap and that the Department of Treasury and Finance (DTF) has improved business cases by applying greater scrutiny to agencies' estimates of costs and time lines, and their analyses of risks.
However, the HVHR process as currently applied falls short of consistently providing the level and quality of assurance government needs to be fully informed when deciding whether and how to invest.
While my report describes the gaps we found and how DTF should address these, two areas of particular concern are, firstly, the absence of any meaningful scrutiny of project benefits and, secondly, the inconsistent coverage of projects costing more than $100 million.
On the first point, DTF's scrutiny of project benefits is insufficient to assure government that these benefits are deliverable. The business cases we reviewed did not include all the information needed to understand and verify the benefits claimed. This is clearly not adequate.
Our previous audit findings highlight that much greater scrutiny of claimed benefits is required. For example VAGO's:
- 2010 audit, Management of Major Rail Projects, found that the quality assurance underpinning final business cases, including the documentation of project benefits, was inadequate.
- 2011 audit, Management of Major Road Projects, found that shortcomings in how agencies forecast traffic and estimated benefits risked themoverestimating benefits and giving decision-makers false confidence about the capacity of projects to cope with future traffic.
The continuing lack of adequate scrutiny of project benefits needs to be addressed. It raises the risk of government investing substantial sums in projects without understanding whether the projected benefits are well founded or achievable.
On the second point, we identified projects worth billions of dollars that are not following the standard HVHR process of having a DTF-reviewed and Treasurer‑approved business case before being considered for funding. These include major road and rail projects, funded as part of the government's 2014 election commitments, and projects funded as unsolicited bids.
I have asked DTF to keep me informed about how it will achieve the level of scrutiny and assurance needed to properly inform government decisions about these projects.
I note DTF's positive response to the audit recommendations. Given the importance of this area, I plan to conduct one performance audit each year on the HVHR process to track DTF's progress and identify emerging issues.
I would like to thank DTF, the Department of Transport, Planning and Local Infrastructure, the Department of Health, VicRoads and Public Transport Victoria for their assistance and cooperation during this audit.
John Doyle
Auditor-General
June 2014
Audit Summary
Background
In Victoria, the total value of public sector capital investments underway or commencing in 2014–15 is around $72 billion, including projects delivered as public private partnerships. This includes a commitment made in the 2014–15 Budget of up to $27 billion to build new road and rail infrastructure such as the $8 billion to $10 billion stage 2 of the East West Link and the $8.5 billion to $11 billion Melbourne Rail Link.
Previous VAGO and Ombudsman reviews have found that significant flaws with project business cases and procurement processes have led to cost and time overruns and diminished benefits.
The government adopted the High Value High Risk (HVHR) process in late 2010 because of past cost overruns of over $2 billion that it attributed to the inadequate management of project business cases and procurements. The goal of the HVHR process is to achieve more certainty in the delivery of intended benefits in line with planned costs and time lines.
The HVHR process applies to all public sector infrastructure and information and communications technology investments that are likely to draw on Budget funding that:
- have a total estimated investment greater than $100 million, or
- are identified as high risk using an approved risk assessment tool, or
- aredetermined by government as warranting the rigour of increased oversight.
HVHR investments are subject to extra scrutiny by the Department of Treasury and Finance (DTF), together with additional Treasurer's approvals at key milestones covering the business case and procurement, and monitoring after the procurement decision. HVHR reviews started in 2011 to cover projects in the 2012–13 Budget cycle.
This audit examined the effectiveness of the HVHR process in improving project business cases and procurements so that they provide an adequate basis for delivering intended project benefits within approved time lines and costs. We assessed whether the process has:
- been applied as intended to assess business cases, procurement approaches and contractual and governance arrangements for all relevant HVHR projects
- resulted in improved business cases that provide a comprehensive and rigorous basis for government project decisions
- resultedin improved procurements and, ultimately, better outcomes.
We examined the application of the process for five projects valued at $936 million:
- the registration and licensing system (RandL)
- Mitcham Road and Rooks Road rail grade separations
- Royal Victorian Eye and Ear Hospital redevelopment
- Western Highway duplication from Beaufort to Buangor
- regionalrolling stock purchase.
Towards the end of the audit we examined a further three projects to assess the impact of DTF updating its business case assessment template in late 2012.
Conclusion
Based on our review of these projects, DTF's increased scrutiny applied through the HVHR process has made a difference to the quality of the business cases and procurements underpinning government's infrastructure investments. However, DTF has not yet started formally evaluating the impacts of the application of the HVHR process on project outcomes.
These improvements have not lifted practices so that they consistently and comprehensively meet DTF's better practice guidelines. This means government is still exposed to the risk that projects fail to deliver intended benefits on time and within approved budgets. A robust HVHR process is critical to effectively managing this risk.
DTF's scrutiny and assurance of HVHR projects was not applied comprehensively or consistently across all the 'deliverability' criteria. Its performance was best when assuring project costs, time lines and agencies' approaches to risk management. It was more mixed for procurement, governance and project management, and clearly inadequate when assuring the expected project benefits. Of particular concern was the lack of substantive HVHR review of project benefits, given that none of the business cases adequately justified these.
This audit identified gaps and inconsistencies in DTF's approach to identifying projects that should be subject to HVHR review, specifically in relation to small value projects that may have high risks and projects that were delivered outside of the general government sector.
It also identified the need for more comprehensive assessment guidance for HVHR analysts, the application of a standardised file structure and comprehensive central register for managing reviews and the need for better identification and management of potential conflicts of interest.
The RandL project is one of the projects this audit examined in detail. It is the type of complex project that HVHR is meant to deal with and an example of a project where significant, negative deliverability risks have materialised. While the RandL project commenced well before the HVHR process started, the updated 2011 business case was subject to an HVHR type review and the project has been monitored under HVHR since late 2011.
However, neither the management nor oversight applied to the RandL project, including HVHR monitoring, was effective in detecting or controlling risks before they materialised to significantly delay the project and increase the estimated cost of delivery. A key reason for this was the lack of skills and depth of experience needed to manage and oversee a complex project of this type.
The government has now decided to pause the project until February 2015. It is currently running at least 18 months late, has cost around $102 million and VicRoads has proposed additional expenditure of up to $135 million more than the approved budget of $158 million.
Findings
Management of the HVHR process
There is clear scope for DTF to improve how the HVHR process is managed, to make it more efficient, transparent and accountable. DTF's May 2012 internal audit and VAGO's 2013 audit of the Gateway Review Process recommended changes that DTF has not yet fully addressed.
DTF's HVHR process captures projects valued above $100 million that rely on funding from the State Budget. However, the audit identified management weaknesses that DTF needs to address, including:
- acting on VAGO's previous findings about gaps in its approach to assessing whether projects valued between $5 to $100 million should be in the HVHR process
- providing criteria for assessing whether non-Budget-funded projects typically funded by public corporations should be captured by the HVHR process
- extending the detailed guidance and templates provided to DTF analysts for business case assessments to cover the entire HVHR process
- better administering the process by applying a standard documentation and record-keeping approach to all reviews, and maintaining a master register which comprehensively documents review activities
- improving the collation and communication of lessons learned and better practices observed across all HVHR reviews
- applyingan evaluation framework to reliably measure the outcomes of the HVHR process and understand further areas for improvement.
Improving the quality of reviews
HVHR business case reviews raised substantive issues and agencies frequently modified submissions to address these issues. However, this did not consistently occur across all projects nor for all the criteria that DTF uses to test a project's deliverability.
For four of the five business cases we looked at in detail we saw evidence of:
- substantive reviews following an HVHR review template
- DTF identifying and constructively communicating issues to departments
- responses to DTF's comments providing greater assurance about the rigour of the project and in some cases resulting in changes to business cases to reflect this information
- adviceto the Treasurer which accurately reflected review findings and conclusions.
However, there is considerable room for DTF to improve its administration and oversight of the HVHR process. Some improvements do not require much change—for example, making sure that business cases are updated where additional significant information is provided. However, other improvements, such as adequately testing the reliability of project benefits, require a step change in approach and acquisition of the skills needed to do this.
Recommendations
That the Department of Treasury and Finance:
- improves its approach to selecting projects for inclusion in the High Value High Risk process by:
- systematically reviewing projects between $5 million and $100 million to determine whether they should be subject to the High Value High Risk process through documented reviews of project risk assessments
- clarifying the criteria for selecting public projects that do not require Budget funding for inclusion in the High Value High Risk process
- recommending that projects over $100 million selected under the government's unsolicited bids policy be subject to High Value High Risk processes
- develops assessment guidance and templates covering all High Value High Risk stages to improve the consistency, rigour and transparency of High Value High Risk reviews
- improves its administration of the High Value High Risk process by:
applying a standardised file structure for managing assessment documents and supporting evidence
developing and maintaining a comprehensive central register of High Value High Risk review activity by project and High Value High Risk process stage
- identifies potential conflicts of interests of reviewers and documents how these are mitigated
- develops and applies an evaluation tool to measure the extent to which the High Value High Risk process is affecting project outcome
- provides greater assurance that High Value High Risk reviews comprehensively test compliance with its Investment Lifecycle and High Value High Risk Guidelines in areas critical for project deliverability

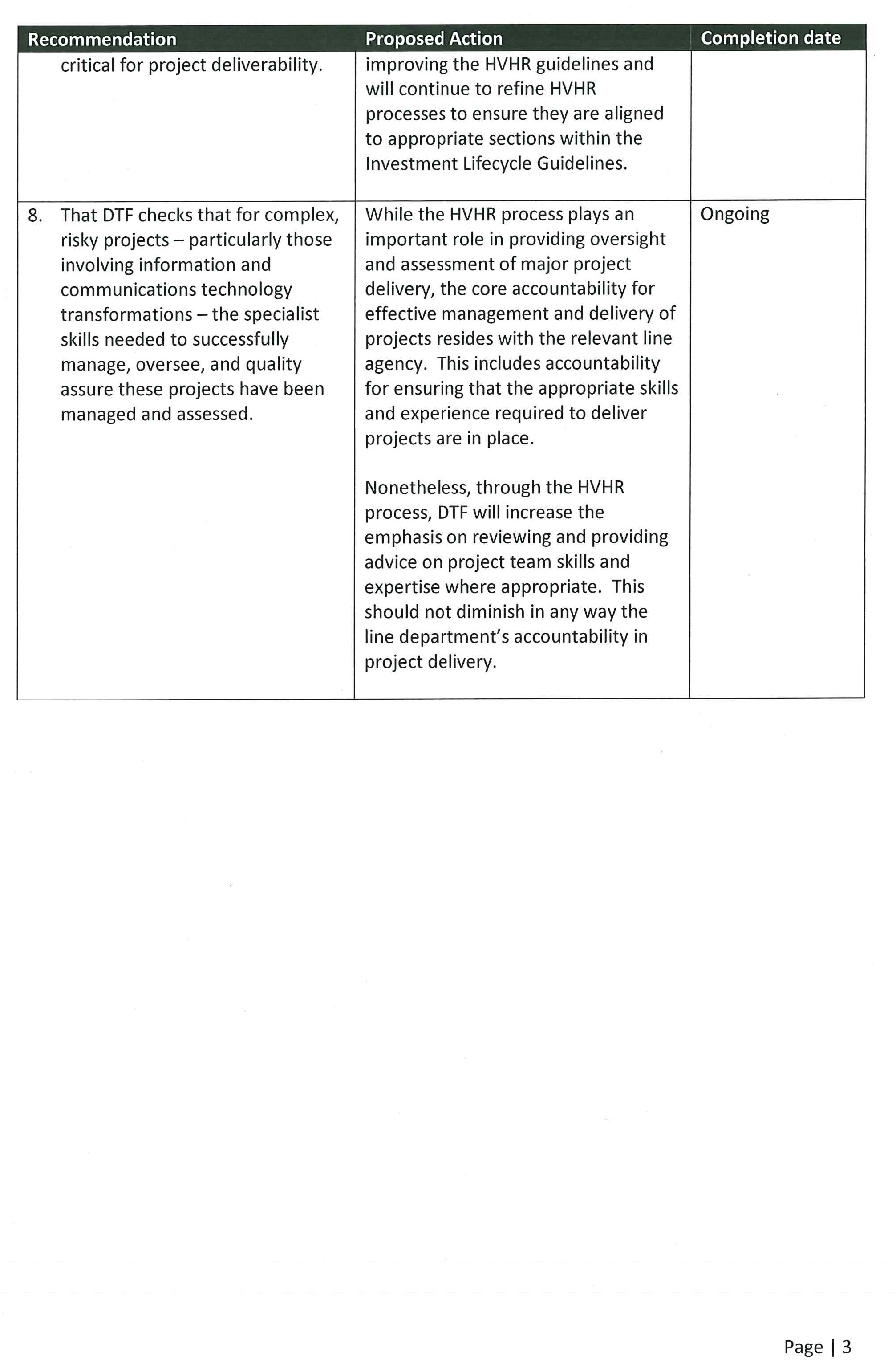

- checks that for complex, risky projects—particularly those involving information and communications technology transformations—the specialist skills needed to successfully manage, oversee and quality assure these projects have been assessed and acquired.
- improves how it communicates with and informs departments by:
- developing a structured approach to collating and sharing the lessons from all High Value High Risk reviews
- completing an annual satisfaction survey of agencies that have been subject to High Value High Risk reviews
Submissions and comments received
In addition to progressive engagement during the course of the audit, in accordance with section 16(3) of the Audit Act 1994 a copy of this report was provided with a request for submissions or comments to:

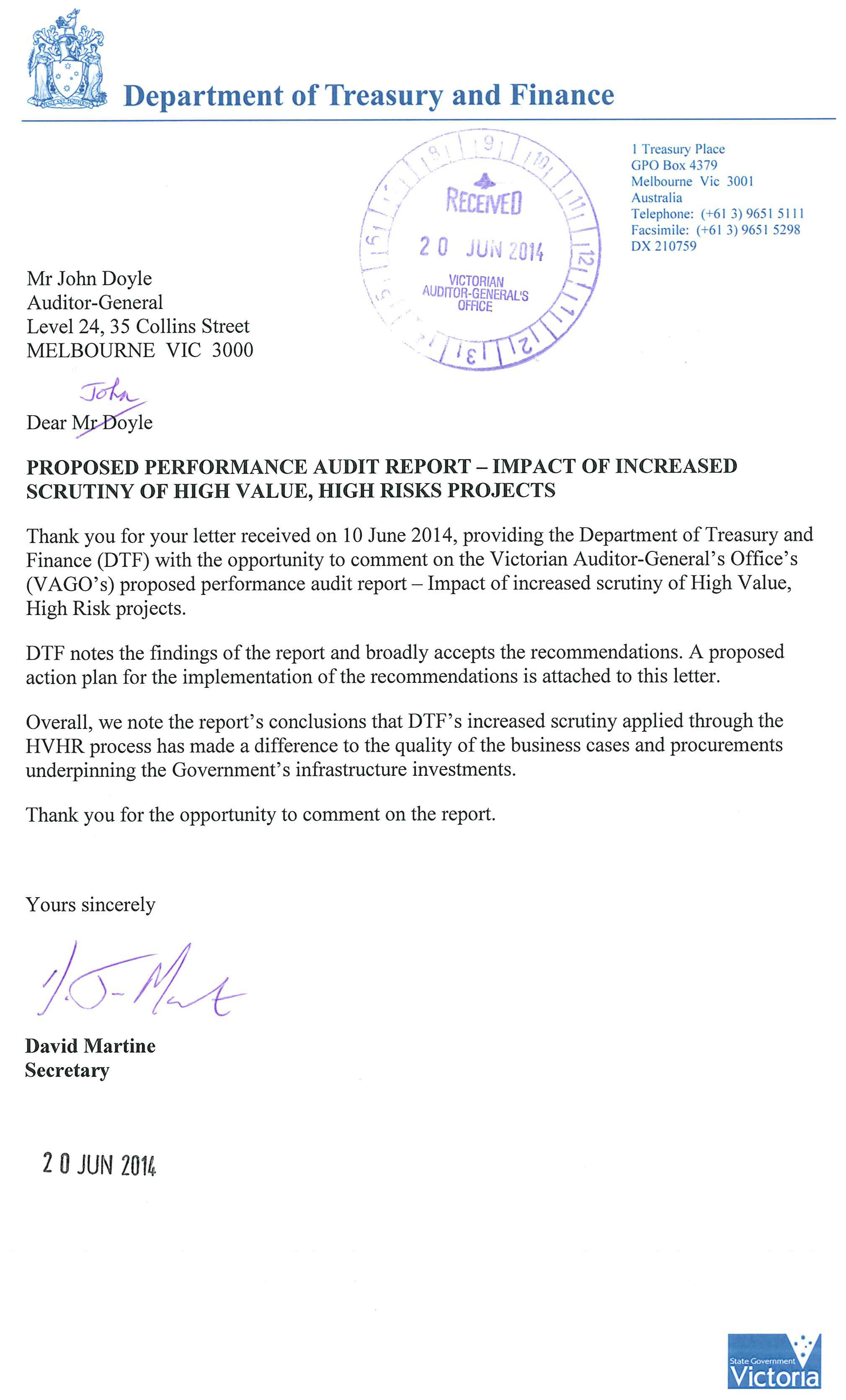

- Department of Treasury and Finance
- Department of Transport, Planning and Local Infrastructure

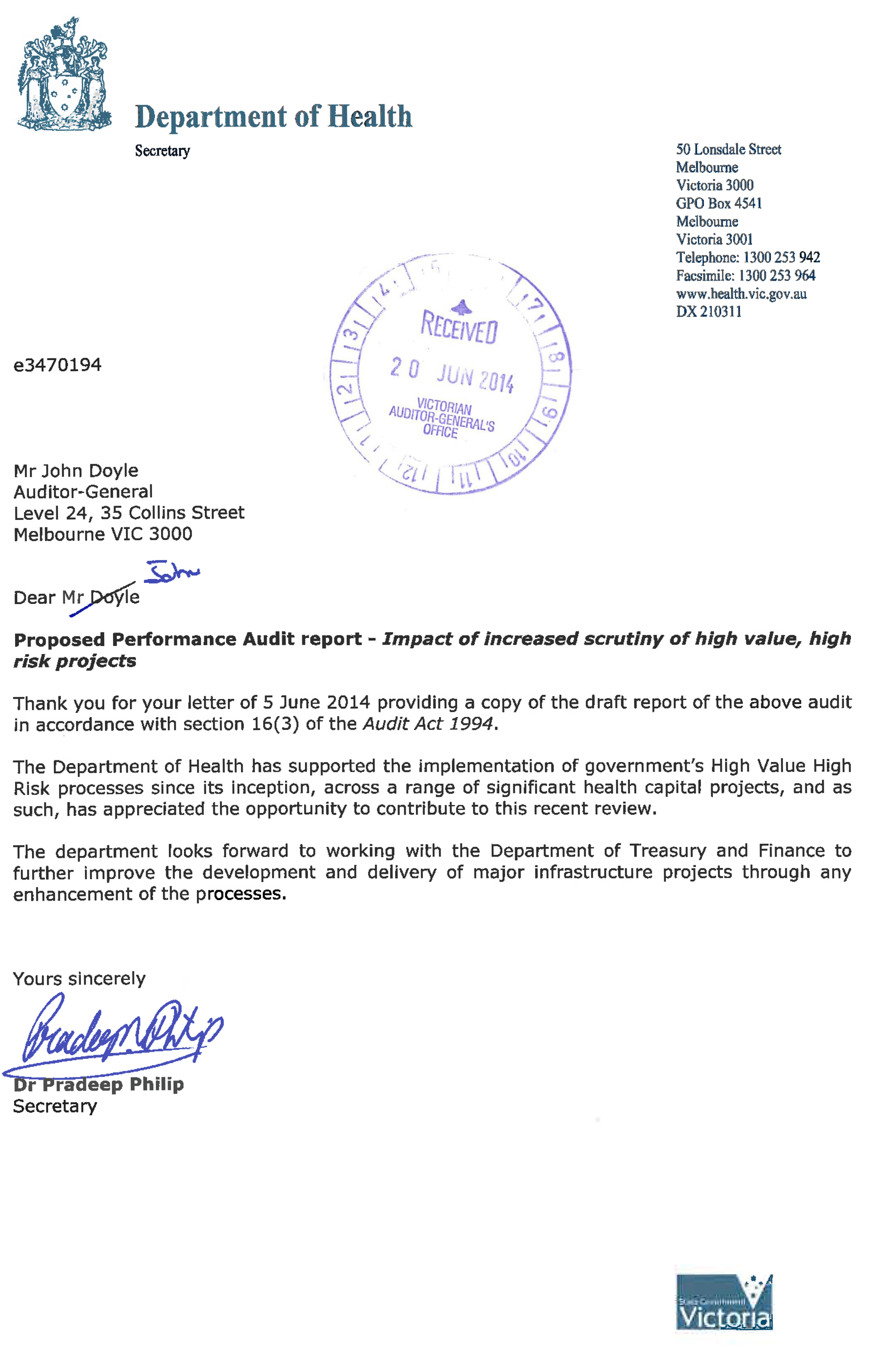

- Department of Health

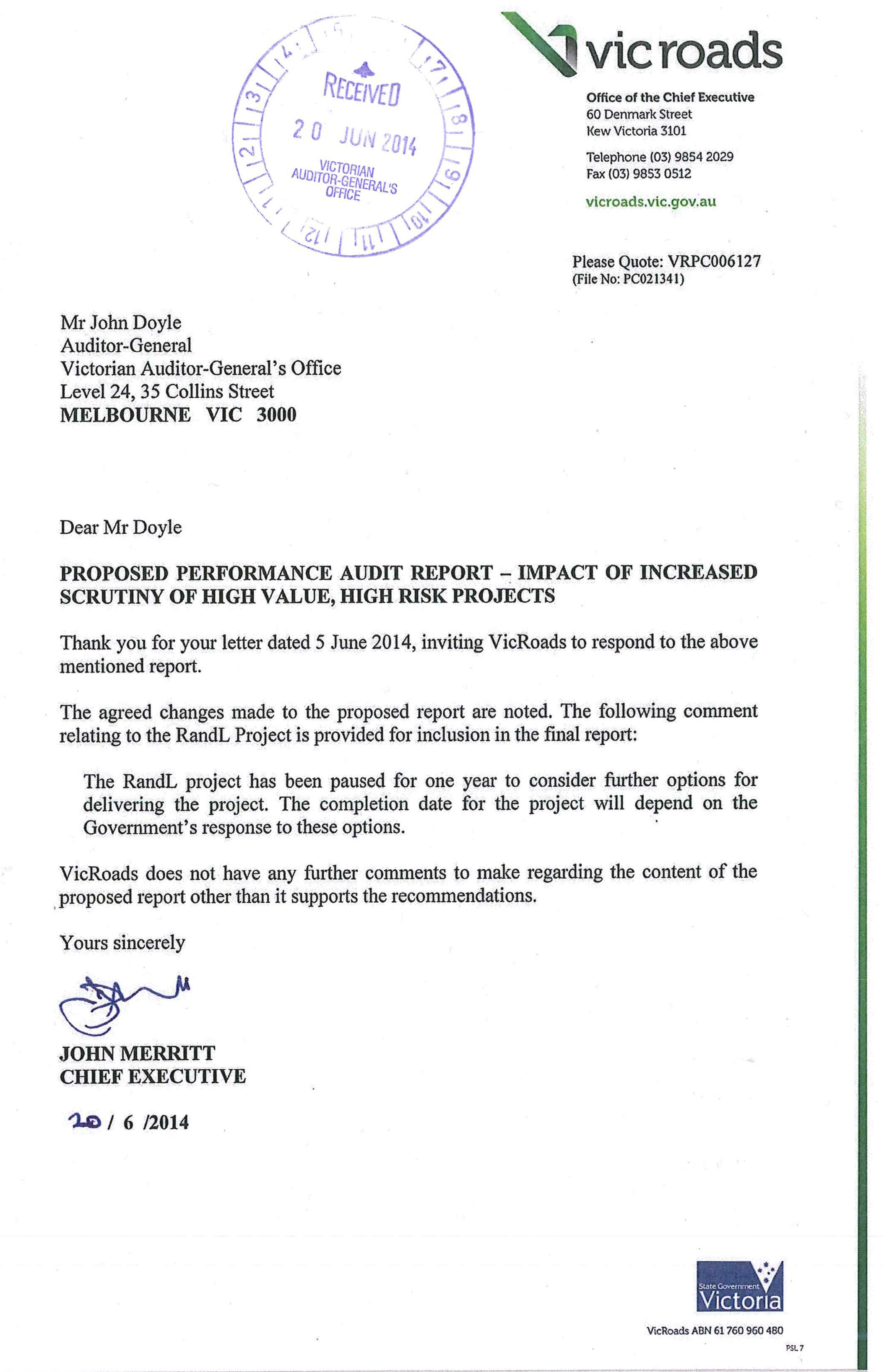

- VicRoads

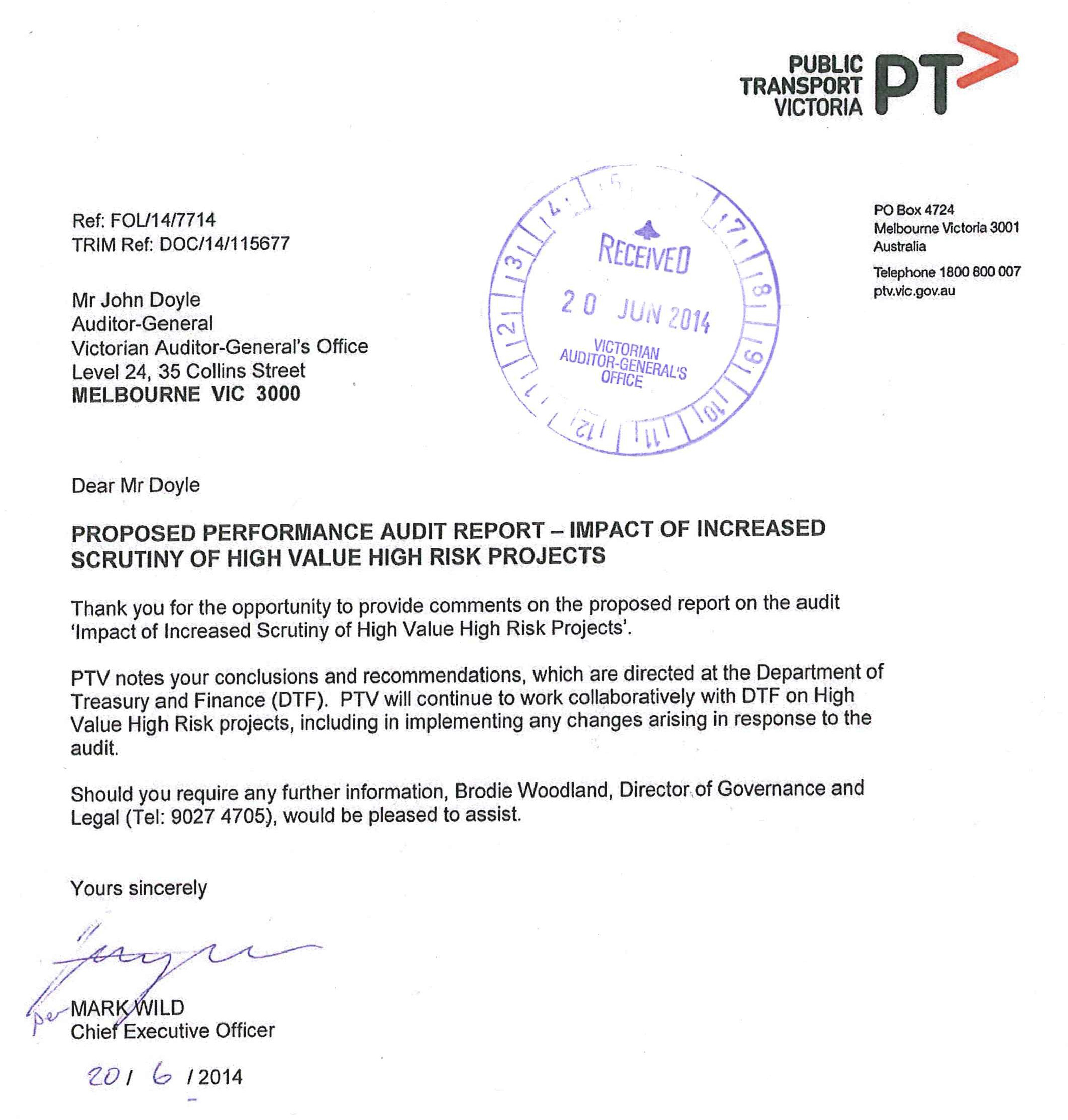

- Public Transport Victoria.
Agency views have been considered in reaching our audit conclusions and are represented to the extent relevant and warranted in preparing this report. Their full section 16(3) submissions and comments are included in Appendix A.
1 Background
1.1 Introduction
1.1.1 Infrastructure planning and delivery
Effective planning and delivery of major infrastructure projects is critical for governments to achieve their policy objectives. In Victoria, the total value of public sector capital investments underway or commencing in 2014–15 is around $72 billion.
The 2014–15 Budget commits up to $27 billion in new infrastructure including:
- $8.5 billion to $11 billion for the Melbourne Rail Link, which includes a tunnel linking Southern Cross and South Yarra stations and a new airport rail link
- $8 billion to $10 billion to complete the East West Link by extending the eastern section from the Tullamarine Freeway to the Western Ring Road
- $2 billion to $2.5 billion to upgrade the Cranbourne–Pakenham Rail Corridor
- $850 million to widen the Tullamarine Freeway approaches to the airport.
This substantial investment requires effective oversight. However, reviews by VAGO and the Ombudsman found that significant flaws with project business cases and procurements have led to cost and time overruns as well as diminished or unclear benefits. These findings highlight the critical importance of the more stringent review processes examined here.
1.1.2 Goal of the HVHR process
In late 2010 the government introduced the High Value High Risk (HVHR) process to address issues related to inadequate project management that resulted in cost overruns of $2 billion. The goal of the HVHR process is to achieve more certainty in the delivery of intended benefits to planned costs and time lines through more rigorous review of business cases and procurements.
By 2008 the Department of Treasury and Finance (DTF) had developed Investment Lifecycle Guidelines that were mandated for investments over $5 million. Since 2010, these guidelines have been updated so that they support the development of business cases, which are mandatory for capital investments with a total estimated investment of $10 million or more. DTF stated to the Public Accounts and Estimates Committee Inquiry into Effective Decision Making for the Successful Delivery of Significant Infrastructure Projects that the 'HVHR processÖ is directed at ensuring the guidance and processes are thoroughly and consistently applied'.
In introducing the HVHR process, DTF advised government that the priority was to:
- enforce the requirement for a robust business case with clear project objectives, well-defined benefits, a rigorous appraisal of options, selection of appropriate procurement methods and appropriate governance and management
- clearly articulate a tender proposal, appointment approach and contract management framework that appropriately allocates and manages risk, delivers benefits and effectively manages scope and cost.
1.2 Victoria's approach to managing investments
1.2.1 Guidance
DTF's investment lifecycle framework guides agencies to derive maximum benefit from investments by helping them to:
- conceptualise an investment by establishing the need and defining the benefits
- prove a solution by assessing the costs, benefits and risks of likely options
- procure the investment by awarding a contract that best delivers the solution and provides value for money
- implement the solution to realise benefits and manage costs and risks
- realise the benefits and measure the success of the investment.
Figure 1A shows the guidelines, tools and templates DTF makes available so that agencies can effectively navigate this pathway. It also shows the role of the Gateway Review Process—or 'Gateway'.
Figure 1A
Investment lifecycle and HVHR guidelines, tools and templates
Source: Department of Treasury and Finance, Investment Lifecycle and High Value/High Risk Guidelines—Overview (2014).
1.2.2 Review and oversight of government investments
The mechanisms for reviewing the rigour and progress of investments from concept through to benefit realisation and informing government funding decisions are:
- departmental, quality-assured documentation—justifying the investment and its procurement and implementation approaches
- DTF review and advice to government—the value and complexity of each investment determining the depth and type of review applied
- the Gateway Review Process—examining investments at key decision points and providing advice to the project's senior responsible person.
Figure 1B shows what the review process looks like for a complex, risky or high value project where all these review layers are applied. The HVHR process involves strengthening DTF's review of investments up to and including implementation and the following Section defines the scope and content of HVHR reviews.
Figure 1B
Investment review process
Source: Department of Treasury and Finance, Investment Lifecycle
1.3 Scope and content of the HVHR process
1.3.1 Investments captured by HVHR
The HVHR process applies to all general government sector infrastructure and information and communications technology investments that are likely to draw on Budget funding and:
- have a total estimated investment greater than $100 million, or
- are identified as high risk using an approved risk assessment tool, or
- are determined by government as warranting the rigour of increased oversight.
The general government sector includes approximately 200 agencies that directly provide public services such as departments, public hospitals and further education institutes.
While the process is primarily applied to Budget-funded investments, it can—at the government's discretion—be applied to investments by state-controlled corporations that sit outside the general government sector. These are the seven public financial corporations, e.g. the Treasury Corporation of Victoria, and around 80 public non‑financial corporations, e.g. the Port of Melbourne, water corporations and Alpine Resorts.
These reviews are discretionary because investments in these entities are usually not funded from the State Budget but made on a commercial basis from their own resources.
DTF's public statements around this issue are not uniformly consistent and clear, with reference to the inclusion of all investments over $100 million 'regardless of the funding source' on its website. The audit examines this clarity issue in Part 2 of this report.
1.3.2 Structure and content of the HVHR reviews
The HVHR process builds on DTF's existing Investment Lifecycle Guidelines and Gateway reviews. HVHR investments are subject to extra scrutiny by DTF and additional Treasurer's approvals at the following stages—for the business case deliverability assessment, at critical milestones during procurement and for significant variations after contract sign off.
Within the HVHR process, DTF also monitors critical recommendations arising from Gateway reviews on 'Concept and Feasibility' (Gate 1) to 'Tender Decision' (Gate 4).
Preliminary business case
DTF advises government on strategic merit and need and whether the proposal should be developed into a full business case.
This review is clearly part of the HVHR assessment because DTF's guidance documentation indicates that only HVHR projects must submit a preliminary business case. Non-HVHR projects instead submit a less extensive strategic assessment.
The key decision is whether a project should proceed to a full business case based on a preliminary assessment of strategic merit, an early options assessment and the project's likely costs, benefits and risks—including a high level cost-benefit analysis.
Full business case
DTF provides advice to inform the Treasurer's decision on whether the case is sufficiently robust to be submitted to government for funding by advising whether it is confident that the project's intended benefits can be delivered on time and within budget. The government's assessment—also informed by DTF and the Department of Premier and Cabinet—goes beyond deliverability to also review the policy merit, affordability, scale and alignment of the proposal.
DTF has a template for its analysts on the scope, approach and documentation of HVHR full business case reviews. This template was initially developed in 2011 and updated in late 2012.
DTF's assessment focuses on providing government with assurance that projects are 'deliverable'. Figure 1C outlines this definition. At this stage, DTF needs to establish whether a well thought through plan has been developed to deliver the project as outlined in the business case.
Figure 1C
Project deliverability definition
An assessment of project deliverability is DTF's judgement on whether the business cases can achieve the:
|
After it does this assessment, DTF can recommend to the Treasurer that the project:
- proceed for funding consideration—i.e. DTF assesses the project as deliverable
- proceed for funding consideration subject to further refinement of identified issues—i.e. DTF assesses the project as deliverable if the final business case submitted for funding is updated to address specific issues
- not proceed—i.e. DTF assesses the project as unlikely to be deliverable.
Figure 1D shows how DTF addresses deliverability by assessing the project as conveyed in the business case across seven key areas. Analysts should cover these areas when assessing business cases for HVHR projects, supporting responses with a clear rationale and sufficient evidence to justify their assessments.
The final DTF recommendation about whether to proceed is based on a balanced assessment, taking account of the responses in each of these areas.
Figure 1D
Business case assessment areas
Deliver on budget—assess the comprehensiveness, logic and level of detail of the project costs, the incorporation of risks if alternative funding forms part of the business case and, where there are multiple options, whether these have been soundly costed. Deliver to time lines—assess whether project time lines and milestones are sound and supported by sufficient evidence and adequate plans to deliver as intended. Determine whether the time lines are consistent with those used for similar projects. Deliver benefits—assess whether the business case adequately demonstrates that the project can deliver the intended benefits, and compare the predicted benefits with those achieved by similar projects. Comprehensively manage risks—assess the comprehensiveness of the risk management plan included in the business case and determine whether there are any gaps and whether there is a clear strategy to mitigate material risks. Apply appropriate governance—assess whether the governance structure includes:
Adequately justify the preferred procurement approach—assess whether all suitable procurement options have been considered and whether the business case demonstrates that the proposed procurement strategy is the most effective and value-for-money way to deliver the project. Substantiate the project management approach—assess whether the business case clearly substantiates that:
|
Procurement
DTF provides advice to inform the Treasurer's approval of:
- procurement documentation prior to its release
- the decision on the preferred bid prior to its announcement
- the final contract, prior to signing.
Reviews of tender documentation, the preferred bid decision and the final contract prior to sign-off are meant to ensure that:
- the preferred procurement approach is effectively implemented and translated into a contractual framework that delivers on the best value-for-money approach
- the risks of diminishing this outcome through unintended scope creep or a contractual form that diminishes the outcomes for the state are managed.
Post contract
The HVHR process involves DTF monitoring project progress—including emerging issues and risks and any changes to the project scope and cost that was agreed to in the signed‑off contractual arrangements—and advising the Treasurer about significant changes. The Treasurer approves significant contract variations based on advice from DTF.
Within the HVHR process DTF also monitors projects post contract signing and during delivery through its quarterly reporting process to government and representation on project steering committees or equivalent.
1.4 Reviews relevant to this audit
1.4.1 VAGO audit—Gateway Review Process
VAGO's 2013 audit, Planning, Delivery and Benefits Realisation of Major Asset Investment: The Gateway Review Process, concluded that DTF had not systematically reviewed and verified the agency self-assessments of project risk that determine whether projects are subject to the Gateway reviews.
DTF also uses these assessments to identify risky or complex projects under $100 million that should be covered by the HVHR process.
Part of VAGO's recommendation on this issue required DTF to verify that all new projects had completed robust project risk assessments.
1.4.2 Department of Treasury and Finance internal audit reviews of HVHR
DTF commissioned two internal audit reviews of the HVHR process that reported in May 2012 and May 2014.
Figures 1E and 1F summarise the findings from these internal audits, and Part 2 of this report examines whether DTF has acted on these findings.
Figure 1E
Recommendations from HVHR May 2012 internal audit
# |
Recommendation |
Rating / action |
Internal audit commentary |
---|---|---|---|
1. |
Project business case assessment requirements should be structured and formalised. |
Moderate 30 Sep 2012. |
|
2. |
Bring forward time frames for submission of preliminary/full business cases. |
Moderate 30 Sep 2012. |
|
3. |
A standard file structure should be implemented to assist HVHR process. |
Low 30 Sep 2012. |
|
4. |
HVHR stakeholder engagement/communications activities should be enhanced. |
Low 30 Sep 2012. |
|
5. |
The relationship between HVHR and Gateway may require further clarity. |
Improvement opportunity No date set. |
|
The May 2014 audit was conducted as a separate exercise to the May 2012 audit and did not follow up on the earlier audit's recommendations. It is unclear why the later audit did not examine these earlier recommendations.
Figure 1F shows the recommendations, ratings and commentary of the later report.
Figure 1F
Recommendations from May 2014 HVHR internal audit
# |
Recommendation |
Rating/action |
Internal audit commentary |
---|---|---|---|
1. |
Outcomes from the lessons learnt database should be incorporated into the HVHR business case review process. |
Low 30 November 2014. |
|
2. |
Impacts to project benefits realised should be tracked throughout the project lifecycle. |
Improvement opportunity 30 November 2014. |
|
1.5 Audit objectives, scope and criteria
This audit examined the effectiveness of the HVHR process in improving project business cases and procurements so that they provide an adequate basis for delivering intended project benefits within approved time lines and costs.
It did this by assessing whether the HVHR process has:
- been applied as intended to assess business cases, procurement approaches and contractual and governance arrangements for all relevant HVHR projects
- resulted in improved business cases that provide a comprehensive and rigorous basis for government project decisions
- resulted in improved procurements and ultimately improved delivery and outcomes.
1.5.1 Applying the HVHR process as intended
Part 2 assesses whether DTF's management and application of the HVHR process has been:
- comprehensive—in terms of identifying HVHR projects and completing required reviews
- consistently high quality—in terms of employing capable reviewers and applying a consistent, quality-assured approach to deliver high quality reviews
- underpinned by adequate monitoring and reporting—firstly to government and also to agency stakeholders
- evaluated in terms of its emerging impacts—by developing and applying a framework to measure improved timeliness, cost and benefit realisation.
1.5.2 Impacts on business cases and procurements
Part 3 examines HVHR reviews to determine their impacts on the quality of business cases and procurements and how this is likely to affect project outcomes.
For a sample of business cases we assessed whether HVHR assessments of the deliverability of intended benefits according to planned costs and time lines were robust. We did this by examining whether they provided adequate assurance that projects would:
- deliver on budget
- deliver to planned time lines
- deliver the intended benefits
- comprehensively manage risks
- apply appropriate governance
- apply a procurement strategy that represented value for money
- apply an appropriate and effective project management approach.
We also examined whether the procurement reviews were undertaken as required and contributed to assurance that the procurement approach approved as part of the business case was effectively implemented.
1.6 Audit method and cost
The audit team gathered evidence by examining the application of the HVHR process for five projects, namely:
- Registration and licensing system—this project involves replacement of VicRoads registration and licensing IT systems and changes to supporting processes. The initial estimated cost was $173 million, with completion targeted for April 2013.
- Mitcham Road and Rooks Road rail grade separations—this project is part of the Metro Level Crossing Blitz program and involves separating the rail from the road by lowering the rail tracks beneath Mitcham Road and Rooks Road, in Mitcham. The total estimated cost is $197 million and a target completion date of mid-2014.
- Royal Victorian Eye and Ear Hospital redevelopment—this project involves redeveloping the hospital at a cost of $165 million with a target completion date of December 2017.
- Western Highway duplication from Beaufort to Buangor—this project is part of the $505 million Western Highway duplication project from Ballarat to Stawell, funded by the Commonwealth and state governments on an 80/20 basis. The project budget for the duplication from Beaufort to Buangor is around $140 million. It was contracted in April 2014 and construction is expected to commence in mid-2014.
- Regional rolling stock—this investment involved the procurement of additional rolling stock for the regional rail network with total approved funding of $261 million and an expected final delivery date of August 2016.
These projects were selected to give coverage of projects of different type, scale and complexity and from more than one sector that had been subject to substantial HVHR review and had also moved into implementation.
V/Line VLocity train.Towards the end of audit conduct we added three projects to our sample to test whether the introduction of an updated business case assessment template in late 2012 had improved the quality of reviews.
The additional three projects were:
- Blackburn Road grade separation
- Kilmore Wallan bypass
- Southland station.
Audit evidence was gathered from DTF and the following departments and agencies responsible for planning and delivering the sample projects:
- Department of Health
- Department of Transport, Planning and Local Infrastructure
- Public Transport Victoria
- VicRoads.
The audit was conducted in accordance with section 15 of the Audit Act 1994 and the Australian Auditing and Assurance Standards.
Pursuant to section 20(3) of the Audit Act 1994, any persons named in this report are not the subject of adverse comment or opinion.
The total cost of the audit was $370 000.
1.7 Structure of the report
The report is structured as follows:
- Part 2 examines the management of the HVHR process
- Part 3 examines the impact of the HVHR process.
2 Management of the High Value High Risk process
At a glance
Background
Effectively managing the High Value High Risk (HVHR) process involves establishing a review capacity, applying clear policies and procedures to guide and record reviews, applying rigorous quality assurance, clearly communicating with stakeholders and monitoring and reporting on the process and its outcomes.
Conclusion
There is considerable scope for the Department of Treasury and Finance (DTF) to improve how the HVHR process is managed, making it more efficient, transparent and accountable. DTF has not yet adequately addressed the changes recommended by its May 2012 internal audit and VAGO's Gateway Review Process audit.
Findings
- DTF identifies HVHR Budget-funded projects over $100 million but does not systematically identify lower value high risk projects, or projects funded by public corporations outside the Budget sector.
- HVHR reviews are documented and justified inconsistently because guidelines and templates are not comprehensive. Not applying a standardised file structure and comprehensive central register of HVHR activities diminishes efficiency.
- Lessons from HVHR reviews are not effectively collated and communicated to agencies subject to the HVHR process.
- DTF has not made enough progress in evaluating HVHR process outcomes.
Recommendations
That the Department of Treasury and Finance:
- improves its approach to selecting projects for inclusion under HVHR
- develops assessment guidance and templates covering all HVHR stages
- improves the administration of the HVHR and how it communicates with and informs departments about HVHR
- identifies potential conflicts of interests and documents how these are mitigated
- develops and applies an evaluation tool to measure HVHR outcomes.
2.1 Introduction
Effectively managing the High Value High Risk (HVHR) process involves establishing a review capacity, applying clear policies and procedures to guide and record reviews, applying rigorous quality assurance, clearly communicating with stakeholders and monitoring and reporting on the process and its outcomes.
We assessed whether the Department of Treasury and Finance's (DTF) overall management and application of the HVHR process had been:
- comprehensive—capturing all high value and risky projects within the HVHR process and completing all prescribed reviews (Section 2.3)
- consistently high quality—employing capable reviewers, applying a consistent, quality-assured approach to deliver high quality reviews (Section 2.4)
- underpinned by adequate monitoring and reporting—firstly to government and also to departments so they could understand the process and respond to the lessons learned across all reviews (Section 2.5)
- evaluated in terms of emerging impacts—by applying a framework to measure improved timeliness, budgeting and benefit realisation (Section 2.6).
We have also drawn on VAGO's May 2013 audit Planning, Delivery and Benefits Realisation of Major Asset Investment: The Gateway Review Process and on DTF's internal audit findings and recommendations reported in May 2012 and May 2014.
2.2 Conclusion
There is considerable scope for DTF to improve how the HVHR process is managed to make it more efficient, transparent and accountable. Its May 2012 internal audit and VAGO's audit of the Gateway Review Process (Gateway) recommended changes that DTF has not yet fully addressed.
DTF effectively captures within the HVHR process projects valued over $100 million which rely on funding from the State Budget. However, the audit identified management weaknesses that DTF needs to respond to, including:
- addressing VAGO's previous findings about gaps in DTF's approach to assessing whether projects valued between $5million and $100 million should be in the HVHR process
- providing criteria for assessing whether non-Budget funded projects typically funded by public corporations should be captured by the HVHR process
- extending detailed guidance and templates provided to DTF analysts for business case assessments to cover the entire HVHR process
- better administering the process by applying a standard documentation and record-keeping approach to all reviews and maintaining a master register which comprehensively documents review activities
- improving the collation and communication of lessons learned and better practices observed across all HVHR reviews
- applying an evaluation framework to reliably measure the outcomes of the HVHR process and understand further areas for improvement.
2.3 Comprehensively applying the HVHR process
The HVHR process aims to capture Budget-funded infrastructure and information and communications technology (ICT) investments that are valued at more than $100 million or are assessed as high risk or that the government identifies as requiring more intensive review and oversight.
The five projects we reviewed in detail had been subject to the required HVHR reviews and approvals, with one exception—the regional trains rolling stock project.
For this project the most significant exception was the lack of evidence that the Treasurer approved the request for proposal document. However, DTF adequately justified this on the basis that the Treasurer had approved the procurement strategy for a single supplier to bid. There is no evidence that the absence of approval for the request for proposal document compromised the integrity of the procurement process.
In terms of coverage, DTF has included Budget-funded projects over $100 million within the HVHR process since it was first used in the 2012–13 Budget cycle. However, it is not clear that the HVHR process has been applied to all intended projects, specifically for projects:
- valued between $5million and $100 million that are high risk, because DTF cannot show that it has reviewed risk profile reports when deciding on their HVHR status
- over $100 million that are funded outside of the Budget by public corporations, because there is no systematic assessment process and inclusion is activated only through a specific request by government.
The government announced funding commitments of up to $27 billion as part of the 2014-15 Budget for infrastructure projects, with most ($24 billion) designated as HVHR projects that have not progressed through the HVHR process. These included projects funded under government's unsolicited bids policy and multi-billion dollar projects for a rail tunnel linking Southern Cross and South Yarra stations and stage 2 of the East West Link.
It is currently unclear how the HVHR process will be applied to unsolicited bids and to major projects that have been fast tracked to a funding commitment without any HVHR reviews.
The absence of a comprehensive central, up-to-date register to provide a consolidated record of risk assessments and subsequent reviews for HVHR projects makes it difficult for DTF to demonstrate that the HVHR process is comprehensively applied.
This is an essential management tool and DTF should develop and maintain a comprehensive register.
2.3.1 Identifying HVHR projects
This Section provides the evidence on our overall findings.
Total estimated investment greater than $100 million
DTF has effective processes in place to capture within the HVHR process projects worth more than $100 million that are funded through the State Budget. Most of these projects are for assets in the general government sector. This sector includes approximately 200 agencies directly providing public services such as departments, public hospitals and further education institutes. It excludes seven public financial corporations, such as the Treasury Corporation of Victoria and, around 80 public non‑financial corporations, such as the Port of Melbourne Corporation, water corporations and Alpine Resorts.
Public corporations outside of the general government sector typically rely on their own finances, not the State Budget, to fund major projects. The major exception is transport investments, which are normally funded through the State Budget but are held by a public corporation, VicTrack.
DTF does not usually include in the HVHR process projects that are funded outside the State Budget unless requested to do so by government. There is also a lack of clarity about whether projects under the recently announced unsolicited bids policy will be subjected to HVHR review.
We found that projects over $100 million listed in the State Budget since the 2011–12 Budget cycle had been reviewed under the HVHR process, with the exception of:
- projects started before the application of HVHR review
- projects funded outside of the State Budget by, for example, water corporations
- expenditure related to a program of projects rather than a single project.
The Public Accounts and Estimates Committee's (PAEC) Report on the 2012–13 Financial and Performance Outcomes of May 2014 identified 33 projects in the 2012–13 Budget Papers valued at more than $100 million that were not designated as HVHR.
DTF confirmed that it does not include non-Budget‑funded projects in the HVHR process unless specifically requested to do so by government. It has advised that HVHR exists primarily to provide Budget-related assurance, and public corporations have a commercial-based oversight overlay to manage investment risks.
However, we note that DTF did not advise PAEC of this. Instead, DTF advised that these projects were not included in the HVHR process because they had started before its application or because the expenditure related to a program of projects rather than a single project.
DTF needs to provide greater clarity by defining the criteria it uses to decide when non‑Budget‑funded projects should be captured by the HVHR process.
DTF also needs to clarify whether proposals received under the government's new unsolicited proposal process, such as the $2.5 billion Pakenham and Cranbourne rail line upgrade, will be captured by the HVHR process. The value of this bid and the absence of a competitive bidding process make the application of the HVHR process to projects like this essential.
DTF advised that it will propose to government that the Unsolicited Proposal Guideline should be updated to provide clarity on the role of the HVHR process.
Identifying high risk projects under $100 million
In 2013, VAGO concluded that DTF had not systematically reviewed and verified agencies' self-assessments used to decide which projects fall within the Gateway Review Process. DTF uses these same assessments to decide whether to include projects in the HVHR process.
Figure 2A summarises our 2013 findings and recommendations to DTF. In summary, VAGO recommended that DTF improve its processes for systematically documenting its reviews of agency risk assessments.
DTF accepted the recommendation but indicated that it was already undertaking risk assessments of projects independent of the Gateway Project Profile Model risk assessment tool.
However, 12 months later, DTF has not provided evidence to show that it now verifies the quality and comprehensiveness of risk assessments for projects under $100 million or undertakes its own risk assessments as part of the HVHR process.
Figure 2A
VAGO risk profiling recommendation and DTF's response
VAGO's 2013 audit on the Gateway Review Process (GRP) concluded that DTF: 'has not systematically reviewed and verified agency self-assessments of project risk, which determine whether projects are subject to the GRP. In many cases, responsible departments and agencies have not undertaken the required GRP risk assessment'. VAGO recommended that DTF: 'systematically validate whether projects should be subject to Gateway review, by verifying that robust project risk assessments are completed for new projects'. DTF's formal response to the recommendation stated that: 'As part of the High Value High Risk (HVHR) framework, DTF already undertakes risk assessments of projects to determine which projects should be classified as HVHR and subject to the Gateway Review Process (GRP). This assessment takes into account risk assessments undertaken by departments (including Project Profile Models) as well as DTF's own independent assessment of risk. DTF will examine further options to improve this process, including enhanced documentation outlining the reasons for DTF's risk assessment of projects.' |
2.3.2 Application of HVHR process to significant projects announced in the 2014–15 State Budget
The 2014-15 Budget commits up to $27 billion in new infrastructure including up to $21 billion on the following two projects:
- $8.5 to $11 billion for the Melbourne Rail Link, which includes a tunnel linking Southern Cross and South Yarra stations and a new airport rail link
- $8 to $10 billion to complete the East West Link by extending the eastern section from the Tullamarine Freeway to the Western Ring Road (stage 2).
These projects are listed as HVHR projects in the Budget Papers but have not progressed through any steps in the HVHR review process normally undertaken for funded projects. This is not how the HVHR process is usually applied to projects over $100 million, which requires the Treasurer's approval to proceed to funding based on a deliverability assessment of the full business case.
Government's funding decisions on the Melbourne Rail Link and East West Link stage 2 projects require the development of a full business case in line with the HVHR process. However, DTF has advised that it intends to apply a tailored HVHR assessment process to these projects to enable project risks to be considered while supporting accelerated time frames. This tailored HVHR process is yet to be defined.
Given the significance and scale of these projects it is critical that DTF determine how it will effectively apply the HVHR process within these truncated timelines to ensure that the project costs, benefits and time lines have been robustly determined.
2.3.3 Applying the HVHR process
There are 11 steps in the HVHR review process covering project development, procurement and post-implementation variations and monitoring, as outlined in Figure 2B. None of these steps are optional. However, during the introduction of the HVHR process in 2011, where well advanced projects were brought into the process, the early stages of review were not retrospectively applied.
This audit examined application of the HVHR process to five projects, namely:
- the registration and licensing system (RandL)
- Mitcham Road and Rooks Road Rail grade separations
- Royal Victorian Eye and Ear Hospital redevelopment
- Western Highway duplication from Beaufort to Buangor
- regional rolling stock procurement.
Figure 2B maps the 11 major HVHR steps against each of the five projects we selected for detailed review.
This shows that mandated HVHR reviews have been completed, except for RandL and regional trains. This is because the HVHR process was introduced in mid-2011, after RandL had already passed through these stages. DTF did not provide evidence that the regional trains contract review or procurement document approval steps were undertaken.
The lack of a comprehensive master register showing all HVHR review activities and a structured and consistent approach to record-keeping made it difficult to extend our process analysis beyond this small sample of projects.
Applying these improvements will provide greater assurance that DTF completes required HVHR reviews.
Figure 2B
Completion of mandatory HVHR review and approval steps
# |
HVHR Step |
RandL |
Mitcham |
Eye & Ear |
RRS |
W. Hwy |
---|---|---|---|---|---|---|
1. |
Review preliminary business case |
N/A |
✔ |
✔ |
✔ |
✔ |
2. |
Review full business case |
N/A |
✔ |
✔ |
✔ |
✔ |
3. |
Approval of full business case |
N/A |
✔ |
✔ |
✔ |
✔ |
4. |
Review procurement documents |
N/A |
✔ |
✔ |
✔ |
✔ |
5. |
Approval procurement documents |
N/A |
✔ |
✔ |
✘ |
✔ |
6. |
Review preferred tender |
N/A |
✔ |
✔ |
✔ |
✔ |
7. |
Approval of preferred tender/bid |
N/A |
✔ |
✔ |
✔ |
✔ |
8. |
Review of contract |
N/A |
✔ |
✔ |
✘ |
✔ |
9. |
Approval of contract |
N/A |
✔ |
✔ |
✔ |
✔ |
10. |
Review of project performance |
✔ |
✔ |
✔ |
✔ |
✔ |
11. |
Approval of major variations |
✔ |
N/A |
N/A |
✔ |
N/A |
Source: Victorian Auditor-General's Office.
2.4 Supporting consistently high-quality reviews
We assessed whether DTF had deployed the processes and resources needed to support consistent, high-quality reviews providing:
- sufficient and well-trained analysts and supervisory staff
- clear guidance about assessment criteria and documenting reviews
- quality assured reviews that are consistent, transparent and free from role conflict and conflict of interest.
2.4.1 Capacity—analysts and supervisory staff
The HVHR process is managed within DTF's Infrastructure Advice and Delivery group. DTF recruited 11 analysts during 2011 to enhance its capacity to complete HVHR reviews. These new staff complemented existing resources and represented a significant increase in DTF's capacity to conduct reviews.
DTF committed to develop and train its analysts to improve the consistency and depth of reviews. There is evidence that analysts are provided with a range of relevant training opportunities. However, DTF is yet to develop and implement structured development and training activities for HVHR analysts.
We acknowledge the critical role of on-the-job coaching, mentoring and feedback about performance. However, a structured program is also needed to provide a consistent level of base training, together with tailored, technical training to address needs and gaps identified through regular assessments of HVHR reviews.
We have not seen evidence of DTF taking a structured approach to reviewing emerging needs and dealing with them using a range of mechanisms, such as a formal training program.
2.4.2 Guiding and documenting HVHR assessments
Developing a comprehensive set of review templates
DTF has developed comprehensive guidance for agencies to develop, procure and implement capital projects in the form of the Investment Lifecycle and High Value/High Risk Guidelines. This material has been progressively expanded and improved.
Achieving consistent, rigorous reviews across multiple HVHR projects using different reviewers represents a significant challenge. DTF recognises that review guidelines and templates should cover every stage of the HVHR process.
However, only the business case review process currently has a template that provides detailed questions addressing the review objectives and requires analysts to consistently document the results of each review. There is room to improve the current business case template to better align it with the requirements of the Investment Lifecycle and High Value High Risk Guidelines that fall within the scope of the HVHR business case review.
DTF also needs to extend the templates to other stages, including preliminary business case review and procurement.
Better documenting and managing HVHR review records
The May 2012 internal audit of HVHR found that 'DTF did not maintain documentation received from departments in a consistent or standardised way, impacting on the ability to obtain a clear audit trail of work undertaken'. It recommended that, 'A standard file structure should be implemented to assist the HVHR process'.
Standardising documents and files would provide a clear audit trail and make the HVHR process more efficient by making it easier for different analysts to understand past review stages when doing the next review stage.
DTF committed that by September 2012 it would develop 'a standardised file structure and assessment documentation to be used for all HVHR projects'.
DTF designed a file structure for this purpose in late 2012, but it has not been consistently applied. The project files we reviewed were not standardised or easily navigable, with significant differences in the type and detail of documentation retained.
This made it more difficult to assess reviews and led to follow-up requests during the audit because information was not on file. DTF should apply a standard file structure and assessment documentation for all stages of the HVHR process.
2.4.3 Quality assurance
When introducing HVHR, DTF committed to applying the process consistently and impartially. This is important, given the significant role of the HVHR process in providing government with assurance about the robustness of project planning and delivery.
We have seen evidence that senior DTF staff review all HVHR review briefings. However, these quality reviews are not in a standard form and do not clearly conclude whether HVHR reviews have adequately addressed the key criteria for assessing material submitted by departments.
For example, with a business case, the quality review should confirm or clarify the HVHR assessment conclusions about whether the analysis and evidence supporting the project's time lines, budget and expected benefits adheres to the Investment Lifecycle and High Value High Risk Guidelines.
At present, the only consistently documented evidence of review is the signature of the reviewer on the relevant brief. This does not provide assurance on the scope and adequacy of the review and is exacerbated by the fact that templates are not in place for HVHR reviews, except for the business case assessment.
A review based on a comprehensive template would provide greater quality assurance and clearly indicate what evidence had been relied on to support the assessment and recommended action.
2.4.4 Understanding and managing perceived conflicts
Concerns about role conflict and confusion created by DTF representatives sitting on steering committees or project boards and also advising government about a project's performance have been previously raised by VAGO, the Ombudsman and PAEC.
Figure 2C summarises the concerns reported by the Ombudsman and PAEC.
Figure 2C
Previous Ombudsman and PAEC findings
Victorian Ombudsman The November 2011 report Own motion investigation into ICT-enabled projects found a lack of clarity about the role of DTF representatives on project steering committees and recommended that the terms of reference for steering committees include details of the role to be played by each person on a committee. Public Accounts and Estimates Committee The December 2012 report Inquiry into Effective Decision Making for the Successful Delivery of Major Infrastructure Projects included a finding that concerns had been raised by VAGO about role confusion for DTF, which is responsible for both assisting with project proposals and assessing those proposals on behalf of government. The committee proposed a revised approach that involved DTF focusing solely on providing assurance to the investor. |
Quality reviews should verify the independence of advice by disclosing and addressing any actual or perceived conflicts of interest. We found evidence of DTF staff, and in some cases the same review analyst, having contributed to the submission development by sitting on a project steering committee. This was the case for three of the five HVHR projects examined during the audit.
DTF agreed that there could be a perception of conflict of interest as a result of fulfilling multiple roles but asserted that there is no actual conflict. It further advised that any perceived or potential conflicts are effectively managed as a result of the following review layers:
- HVHR analyst advice is subject to review by their manager, director and the Deputy Secretary and Secretary of DTF
- the Deputy Secretary Budget reviews DTF advice to the Budget and Expenditure Review Committee (BERC) of Cabinet on Budget issues but has no role in the HVHR process
- DTF's HVHR committee reviews DTF's role in the HVHR process.
These practices do not change VAGO's position that potential conflicts should be documented, together with DTF's approach to managing them, so that those receiving advice are aware of them and of how they are being managed.
2.5 Monitoring and reporting
2.5.1 Communicating with government
DTF committed to more proactive monitoring of investment delivery under the HVHR process when it advised government on its introduction.
DTF's quarterly reports to BERC on HVHR projects and its regular DTF HVHR accountability report are effective in informing DTF senior staff and government on project progress in terms of outputs, time lines and budgets, and about project risks.
However, these reports do not routinely address the achievement of intended project benefits, and projects are typically removed from these reports once implemented.
In addition, these reports have not comprehensively covered all HVHR projects from when they were designated as being subject to the review process. Our analysis shows a lag of over three months for some projects between the time they were designated as HVHR and when they were first included in major project monitoring reports to government and DTF.
The May 2014 internal audit identified the need for more robust monitoring of, and reporting on, progress against proposed benefits—financial and non-financial—throughout the project lifecycle.
DTF recently developed and released to agencies a template to track broader project benefits against those proposed in the business case for all asset investments—i.e. HVHR and non-HVHR investments.
2.5.2 Sharing lessons and better practice with agencies
Periodically reporting on progress and emerging lessons, as well as understanding agencies' views on the benefits and drawbacks from reviews, is critical to realising the potential of the HVHR process.
DTF previously committed to sharing and applying lessons learned and to completing an annual satisfaction survey across participating agencies.
DTF has not fully met these commitments and needs to act on these overdue actions. The evidence shows that:
- DTF manages HVHR reviews on a project-by-project basis and has not systematically communicated key lessons across the sector
- the May 2012 internal audit also recommended that DTF enhance stakeholder communication and engagement. While engaging constructively and intensively around individual project reviews, DTF does not have a structured approach to understanding and learning from agencies' combined experiences of the HVHR process because it does not formally survey them.
Notwithstanding this, DTF provided evidence of actions taken to share some lessons with agencies through presentations and ongoing informal communication. DTF has also progressively updated and enhanced the Investment Lifecycle and High Value High Risk Guidelines material and shared feedback on the quality of HVHR business cases with the Victorian Infrastructure Policy Reference Group. This group includes representatives from government departments.
We sought feedback from agencies on their experience of, and perspectives on, the HVHR process. This feedback was largely positive but agencies were consistent in their desire to see DTF communicate any common lessons or issues identified from distilling the results of HVHR reviews undertaken to date. Other commonly raised issues and comments included:
- a lack of clarity about the timing and scope of application of the HVHR process during its initial introduction
- a gradual improvement in clarity about information requirements for reviews
- time pressures in preparing business cases and adequately addressing issues raised by HVHR reviews
- some projects costing over $100 million are not necessarily complex or high risk because they have common characteristics and are routinely delivered successfully by agencies and so do not necessarily warrant additional scrutiny under the HVHR process.
2.6 Evaluating the impacts of the HVHR process
Like any government-funded program, the most important thing to understand is how well the investment has achieved intended objectives—i.e. making projects more predictable in terms of delivering on time and within budget and realising the benefits that underpin business cases.
DTF committed to undertaking an independent evaluation of the HVHR process and reporting the results to government by June 2014. This review has not been commissioned, and we have seen no evidence of progress towards this. DTF has not developed an evaluation framework, nor collected and processed the data needed to measure the outcomes attributable to the HVHR process.
This is a significant gap that DTF needs to address.
VAGO's recent audit on the Gateway Review Process found that in 2004 the Department of Premier and Cabinet developed a detailed review tool to be used over time to assess the impact of the Gateway process against its underlying objectives, outlined when the process was introduced. This tool was developed in consultation with DTF and departments. The Gateway Supervisory Committee and the government endorsed the review tool in August 2004
The review tool provides a sound basis for ongoing review of the impact of the Gateway Review Process. Despite this, and the government's endorsement, DTF informed us that it has not implemented this tool to evaluate Gateway, nor adapted the tool to evaluate the impact of the HVHR process.
This tool was developed for the Gateway Review Process and would be a good starting point for DTF to measure the impact of the HVHR process.
Recommendations
That the Department of Treasury and Finance:
- improves its approach to selecting projects for inclusion in the High Value High Risk process by:
- systematically reviewing projects between $5 million and $100 million to determine whether they should be subject to the High Value High Risk process through documented reviews of project risk assessments
- clarifying the criteria for selecting public projects that do not require Budget funding for inclusion in the High Value High Risk process
- recommending that projects over $100 million selected under the government's unsolicited bids policy be subject to High Value High Risk processes
- develops assessment guidance and templates covering all High Value High Risk stages to improve the consistency, rigour and transparency of High Value High Risk reviews
- improves its administration of the High Value High Risk process by:
- applying a standardised file structure for managing assessment documents and supporting evidence
- developing and maintaining a comprehensive central register of High Value High Risk review activity by project and High Value High Risk process stage
- improves how it communicates with and informs departments by:
- developing a structured approach to collating and sharing the lessons from all High Value High Risk reviews
- completing an annual satisfaction survey of agencies that have been subject to High Value High Risk reviews
- identifies potential conflicts of interests of reviewers and documents how these are mitigated
- develops and applies an evaluation tool to measure the extent to which the High Value High Risk process is affecting project outcomes.
3 Impact of the High Value High Risk process
At a glance
Background
The High Value High Risk (HVHR) process was introduced to provide more certainty that expected outcomes and benefits for projects would be delivered. This would occur by strengthening the Department of Treasury and Finance's (DTF) support for and scrutiny of projects classified as HVHR.
Conclusion
DTF has improved the scrutiny and quality of business cases and procurements captured by the HVHR process. However, these improvements have not lifted practices so they consistently and comprehensively meet DTF's better practice guidelines. There are gaps and inconsistencies which DTF needs to address if it is to realise the potential benefits of the process.
Findings
- There is clear evidence that HVHR reviews have stimulated agencies to address significant business case and procurement issues.
- However, some business case submissions do not fully meet DTF's better practice guidelines. The observed weaknesses relate to reliable estimation of benefits, justifying a preferred procurement strategy and governance and project management arrangements.
- The problems with the RandL registration and licensing system project flag important lessons about getting appropriately skilled and experienced people in key project and board positions.
Recommendations
That the Department of Treasury and Finance:
- provides greater assurance that HVHR reviews comprehensively test compliance with its Investment Lifecycle and High Value High Risk Guidelines in areas critical for project deliverability
- checks that for complex, risky projects—particularly those involving ICT transformations—the specialist skills needed to successfully manage, oversee and quality assure these projects have been assessed and acquired.
3.1 Introduction
This Part examines the impacts of High Value High Risk (HVHR) reviews on the quality of business cases and procurements for the following five projects:
- registration and licensing system (RandL)
- Mitcham Road and Rooks Road rail grade separations (Mitcham Road)
- Royal Victorian Eye and Ear Hospital redevelopment (Eye and Ear Hospital )
- Western Highway duplication from Beaufort to Buangor (Western Highway)
- regional rolling stock procurement (regional trains).
Towards the end of the audit we examined a further three projects to assess the impact of the Department of Treasury and Finance (DTF) updating its business case assessment template in late 2012.
Royal Victorian Eye and Ear Hospital.Section 3.3 examines whether HVHR assessments of business case deliverability were robust. Section 3.4 examines the procurement reviews and Treasurer's approval of tender documents, preferred bid decisions and the final contracts. Both use the relevant parts of DTF's Investment Lifecycle and High Value High Risk Guidelines as the basis for these assessments.
Section 3.5 summarises our findings for the RandL project, which is the one project that most clearly failed the deliverability test. We also use this section to explain why this happened and the lessons to be drawn from this.
3.2 Conclusion
DTF has improved the scrutiny and quality of business cases and procurements captured by the HVHR process. However, these improvements have not lifted practices so they consistently and comprehensively meet DTF's better practice guidelines. There are gaps and inconsistencies which DTF needs to address if it is to fully realise the potential benefits of the process.
HVHR business case reviews raised substantive issues and agencies modified submissions to address these issues. However, these positive findings were not consistently reflected across all projects nor for all the criteria that DTF uses to test projects' deliverability.
DTF's level of scrutiny and assurance needs to improve across all the 'deliverability' criteria. Its performance was best for assuring project costs, time lines and agencies' approaches to risk management, more mixed for procurement, governance and project management and clearly inadequate for assuring the expected project benefits.
None of the business cases adequately justified projects' benefits and this makes the absence of any substantive HVHR review of the area a cause for concern.
RandL was not fully captured by the HVHR process because its procurement happened well before the process started. However, the updated late-2011 business case was subject to a HVHR type review, and the project was included in the process from late 2011.
The management and oversight applied to the RandL project was not effective in detecting and controlling risks before they materialised to significantly delay the project and increase the estimated cost of delivery. The single most critical cause of this was the absence of sufficiently skilled resources.
3.3 Business case reviews
We tested the quality of the assurance provided by HVHR reviews against the criteria in the HVHR Business Case Deliverability Assessment Guidance document, which replaced an earlier, less detailed guide that used the same criteria.
We applied the Investment Lifecycle and High Value High Risk Guidelines criteria to assess the quality of assurance. Our assessment is based on the documentation provided by DTF.
Figure 3A describes our assessment of HVHR reviews of the business cases of the different projects against six criteria that include a combined assessment of governance and project management.
DTF applied the greatest amount of scrutiny and achieved the highest level of assurance in the areas of project budgets, time lines and risk management.
In contrast, the level of assurance in relation to project benefits, preferred procurement approach and governance and management was lower. In particular, DTF applied little scrutiny to, and asked few questions about, the reliability of project benefits, even though business cases did not contain sufficient information to verify the scope and quantum of these benefits.
There is considerable room for DTF to improve its performance in this area. Some improvements do not require much change—for example, making sure that business cases are updated where additional significant information is provided. However, other improvements, such as adequately testing the reliability of project benefits, requires a major change in approach and acquisition of skills needed to do this.
Figure 3A
VAGO assessment of assurance against HVHR requirements for project business cases
Deliverability criteria |
Mitcham |
Eye&Ear |
RRS |
W Hwy |
RandL |
---|---|---|---|---|---|
Deliver on budget—assurance about costs |
✔ |
? |
✔ |
✔ |
? |
Deliver to planned time lines |
✔✔✔ |
✔✔✔ |
? |
✔ |
? |
Deliver intended benefits: |
? |
? |
? |
? |
? |
Comprehensively manage risks |
✔ |
? |
✔ |
✔ |
? |
Governance and project management |
? |
? |
? |
✔ |
? |
Procure for best value for money |
✔ |
✔✔✔ |
? |
✔ |
NA |
✔✔✔ = Fully assured—There was an updated, reviewed business case which fully addressed the Investment Lifecycle and High Value High Risk Guidelines and provided a high level of assurance.
✔= Improving assurance—There was evidence that HVHR reviews improved the level of assurance while not fully addressing all issues. The significance of these outstanding issues varies from relatively minor, e.g. where business cases were not updated with additional evidence, to more significant, e.g. where DTF has not raised or the agency has not addressed material issues. We provide a commentary on these issues below.
? = Not assured—There was insufficient evidence to be assured about the deliverability of the project.
NA = Not applicable.
Note: 'Mitcham' refers to the Mitcham Road rail grade separation, 'Eye&Ear' refers to the Eye and Ear Hospital redevelopment, 'RRS' refers to the regional rolling stock procurement project, and 'W Hwy' refers to the Western Highway duplication project.
Source: Victorian Auditor-General's Office.
3.3.1 Deliver on budget—assurance about costs
At this HVHR stage departments need to provide a bottom-up, detailed cost estimate, including appropriate and evidence-based allowances for contingencies and risks. We found that DTF applied significant effort in testing cost estimates by questioning their basis and working with departments to address their questions.
Figure 3B shows we rated the RandL and Eye and Ear Hospital projects as 'Not assured' because of significant, unaddressed cost uncertainties. For the remaining projects, we found that DTF's review had clearly improved assurance.
Figure 3B
Findings on costing the recommended solution
Project |
Assessment |
Reasons |
---|---|---|
Mitcham Road |
Improving assurance |
|
Eye and Ear Hospital |
Not assured |
|
Regional trains |
Improving assurance |
|
Western Highway |
Improving assurance |
|
RandL |
Not assured |
See commentary under Section 3.5. |
3.3.2 Deliver to planned time lines
The Investment Lifecycle and High Value High Risk Guidelines require the business case to include a detailed and realistic project implementation schedule which encompasses key milestones, decision points and delivery events.
Figure 3C shows that we assessed the reviews as fully assuring the time lines for Mitcham Road and the Eye and Ear Hospital, improving assurance for Western Highway but not assuring the time lines for the remaining two projects.
Figure 3C
Findings on business case information on project time lines
Project |
Assessment |
Reasons |
---|---|---|
Mitcham Road |
Fully assured |
|
Eye and Ear Hospital |
Fully assured |
|
Regional trains |
Not assured |
|
Western Highway |
Improving assurance |
|
RandL |
Not assured |
|
3.3.3 Deliver the intended benefits
Delivering service outcomes to benefit the community is the key reason for spending public money on infrastructure projects. Managing projects to secure, safeguard, maximise and realise the benefits is therefore essential. This requires an evidence‑based understanding of the expected benefits and any risks to them being realised.
It is worrying that such little review effort has been focused on confirming and securing project benefits. None of the business cases we reviewed included sufficient information to understand either the benefits or risks to their realisation. HVHR reviews have focused little or no effort on examining project benefits but instead focus on costs, time lines and cost-related risks. Figure 3D describes the results.
Figure 3D
Findings on business case coverage of benefit definition and delivery
Project |
Assessment |
Reasons |
---|---|---|
Mitcham Road |
Not assured |
|
Eye and Ear Hospital |
Not assured |
|
Regional trains |
Not assured |
|
Western Highway |
Not assured |
|
RandL |
Not assured |
|
3.3.4 Comprehensively manage risks
DTF's Investment Lifecycle and High Value High Risk Guidelines require the business case to:
- clearly identify and assess key risks associated with the proposed investment
- describe the proposed approach to ongoing risk monitoring and management
- document a risk management strategy.
Figure 3E shows that RandL and the Eye and Ear Hospital did not meet the requirements, while HVHR reviews improved assurance for the remaining three projects, although outstanding unaddressed issues prevent us giving these a 'Fully assured' rating.
Figure 3E
Findings on business case coverage of risk
Project |
Assessment |
Reasons |
---|---|---|
itcham Road |
Improving assurance |
|
Eye and Ear Hospital |
Not assured |
|
Regional trains |
Improving assurance |
|
Western Highway |
Improving assurance |
|
RandL |
Not assured |
|
3.3.5 Apply appropriate governance and management
DTF's Investment Lifecycle and High Value High Risk Guidelines require the business case to demonstrate sound governance and project management arrangements.
Figure 3F shows that none of the sample business cases we examined included sufficient explanation and evidence to fully assure the proposed governance and management arrangements. While some HVHR reviews identified this issue, the weaknesses were not addressed. For the Western Highway we found that the review had improved assurance about these arrangements.
Figure 3F
Findings on business case coverage of project governance and management
Project |
Assessment |
Reasons |
---|---|---|
Mitcham Road |
Not assured |
|
Eye and Ear Hospital |
Not assured |
|
Regional trains |
Not assured |
|
Western Highway |
Improving assurance |
|
RandL |
Not assured |
|
3.3.6 Best value-for-money procurement
The Investment Lifecycle and High Value High Risk Guidelines require a range of procurement options to be considered and analysed. This analysis should be sufficient to demonstrate the basis for selecting the recommended procurement approach. Figure 3G sets out our findings on the extent to which the five sample business cases met these requirements.
Only one of the business cases was assessed as meeting the requirements. Three business cases did not fully meet the requirements, primarily because they lacked supporting information or analysis to justify the assessments of different procurement approaches against the evaluation criteria.
Figure 3G
Findings on business case analysis of procurement approaches
Project |
Assessment |
Reasons |
---|---|---|
Mitcham Road |
Improving assurance |
|
Eye and Ear Hospital |
Fully assured |
|
Regional trains |
Not assured |
|
Western Highway |
Improving assurance |
|
RandL |
Not applicable |
|
3.3.7 Further reviews using an updated template
DTF analysts assessed the business cases for the five projects examined earlier in this section using a HVHR template dating from early 2012. DTF updated this template in November 2012. The scope of the HVHR business case reviews did not change over this time, but the updated template is better structured and provides analysts with more detailed guidance on questions to address when reviewing a business case.
We conducted a rapid assessment of three further business cases to determine whether using the updated template had affected the quality of HVHR reviews for:
- the Blackburn Road grade separation
- the Kilmore–Wallan bypass
- Southland station.
We concluded that the new template did not materially change our findings and conclusions from the earlier analysis of five business cases. Our review of the three business cases that were assessed by DTF using an updated assessment template shows that opportunities remain to improve the depth and rigour of HVHR reviews.
Consistent with our findings on the HVHR reviews of the initial sample of business cases, DTF applied the greatest scrutiny and achieved the highest level of assurance for project budgets, time lines and risk management.
When we reviewed the assessments of these further business cases against each of the deliverability criteria we found:
- Deliver on budget—assurance about costs—DTF continues to mainly focus on scrutinising the cost of the recommended solution.
- Deliver to planned time lines—DTF's level of inquiry is similar to that exercised using the initial template. The business case content was adequate for the Blackburn Road grade separation, but the material provided in the Kilmore Wallan bypass and Southland station business cases did not fully comply with the guidelines.
- Deliver intended benefits—we again found that this is an area subject to minimal, if any, scrutiny by DTF.
- Comprehensively manage risks—while DTF did focus its efforts on reviewing agencies' risk management, we are not fully assured about the adequacy of the risk identification and management material in the business cases for the Blackburn Road grade separation and Southland station projects.
- Governance and project management—use of the updated template has not addressed our concern that DTF's HVHR assessments do not provide sufficient assurance about the adequacy of governance and project management.
- Procure for best value for money—use of the updated template has not fully addressed our concern that DTF does not gain sufficient assurance that agencies adequately demonstrate the basis for selecting a preferred procurement approach. None of the business cases met this standard, and DTF only identified this as an issue for two of the projects—the Blackburn Road grade separation and Southland station.
HVHR review of the Southland station project
Southland station was included in, then withdrawn from, the HVHR process when DTF understood that the major issues affecting its deliverability had been resolved. However, there was no documented confirmation that the substantive deliverability issues raised in DTF's HVHR reviews had been satisfactorily resolved. This should have formed part of the close-out process.
Building Southland station was a November 2010 election commitment and the government allocated $700 000 in the 2011–12 Budget to develop a business case.
While the station cost falls well short of $100 million, the government included the project in the HVHR process because:
- completion required access to land owned by the adjacent shopping centre
- the actual scope and cost depended on negotiations with the shopping centre about how best to link it to the station and the size of the shopping centre's financial contribution to the project.
DTF reviewed versions of the business case in January 2012 and January 2013 advising, on both occasions, that the project should not be considered for funding because of deficiencies in these business cases which included:
- lack of clarity around the shopping centre's financial contribution
- absence of an access agreement to allow construction risk to be effectively managed
- insufficient detail around the costs, time lines, risk management, governance, procurement and project management.
The government decided to include the project in the 2013–14 Budget, allocating funding in the central contingency, with its release subject to:
- reaching agreement on the shopping centre's financial contribution and access
- approval being secured under the HVHR process.
In April 2014, the Treasurer approved release of funding for the project and its removal from the HVHR process based on confirmation that an access agreement had been reached with the owner of the shopping centre and that this did not involve any financial contribution from the owner.
However, the business case had not been updated and subjected to further HVHR review to confirm that deficiencies identified in previous reviews had been satisfactorily addressed following resolution of the agreement with the owner of the shopping centre.
3.4 Tendering and appointment reviews
3.4.1 Introduction
We used the Investment Lifecycle and High Value High Risk Guidelines to inform our review of DTF's HVHR assessments of tender documentation, the preferred bid decision and the final contract prior to sign-off. The assessments are meant to ensure that:
- the preferred procurement approach is effectively implemented and translated into a contractual framework that continues to represent the best value for money
- the risks of diminishing this outcome through unintended scope creep or a contractual form that diminishes the outcomes for the state are managed.
The additional approval requirements for HVHR projects include reviews and Treasurer's approvals at the following stages:
- expression of interest—prior to release
- request for tender/proposal—prior to release
- preferred bid selection—prior to announcement
- final contract—prior to signing and any major variations.
The role of DTF is to analyse the documentation and advise the Treasurer, using high level guidance and a standard briefing format. However, in contrast to its analysis of business cases, DTF has not developed a detailed assessment template to guide reviews at these other stages.
3.4.2 Overall findings
We found evidence that DTF:
- Completed the required reviews for all five projects, as required by the guidelines, except for the approval of the request for proposal document and contract review for regional trains. However, DTF adequately justified this because the Treasurer had approved the invitation of a single bidder through the procurement strategy document and the contract used was identical to that used for previous rolling stock procurements.
- Actively engaged departments for each of these projects and asked a range of reasonable questions to which departments responded.
For two of the five projects the same DTF staff were involved in both advising the Treasurer on HVHR procurement reviews and assessing the bid(s). For:
- regional trains, the DTF analyst sat on the procurement panel and wrote the memos advising the Treasurer—these were reviewed by line management
- the Eye and Ear Hospital, a DTF assistant director sat on the procurement panel and reviewed the memos advising the Treasurer.
We understand that this advice was subject to input and review by DTF staff apart from the person with a potential conflict. However, potential conflicts should be documented, together with an approach to managing them.
We found that in assessing expressions of interest, request for tenders, preferred bids and final contracts, DTF did not apply a consistent approach to examining the underpinning documents, such as procurement, probity, risk management and tender evaluation plans. Figure 3H shows our detailed findings on the procurement reviews.
Figure 3H
Findings on HVHR procurement reviews
Project |
Findings |
---|---|
Mitcham Road |
|
Eye and Ear Hospital |
|
Regional trains |
|
Western Highway |
|
RandL |
|
3.5 Registration and licensing system project
3.5.1 Introduction
We have dedicated this section to the RandL project because past management actions and oversight efforts have not stopped the realisation of significant delays and cost overruns.
The project is meant to transform registration and licensing processes and the supporting information and communications technology (ICT) systems in order for VicRoads and other agencies that rely on these systems to:
- improve data integrity and accessibility
- improve efficiency, flexibility and responsiveness
- put customers at the centre of the upgraded system
- reduce the potential for fraud.
Figure 3I shows the project's major milestones, describing:
- the approval of a 2009–10 business case for the system costed at $173 million
- how the project was paused in mid-2011 and restarted in late-2011 with a revised, approved cost of $158 million and a scheduled delivery of the entire system through a single phase deployment by mid-2014
- how the project was paused again in early 2014 because the projected costs had increased to $293 million and the time lines extended by 18 months.
3.5.2 Conclusion on RandL's management and oversight
The management and oversight applied to RandL did not effectively foresee and control risks before they materialised to significantly delay the project and increase the estimated cost of delivery. VicRoads has proposed additional expenditure of up to $135 million more than the approved budget of $158 million to finish it. This would mean a total project cost of $293 million—85 per cent more than the approved budget of $158 million.
The single most critical cause of these poor outcomes has been the absence of human resources with the skills and depth of experience needed to manage and oversee a project of this type and complexity.
Critical gaps existed in three key areas—management, oversight and governance, and independent review—which did not detect and respond to the risks inherent in this type of project up to the middle of 2013 because:
- VicRoads did not appoint a project director with sufficient ICT implementation experience until the middle of 2013. This new executive played a key role in understanding and starting to address this shortfall.
- The board did not include sufficient ICT project deployment and business change experience until April 2013.
- The review of the 2011 business case that informed DTF's advice to government on the continuation of the project in late 2011 did not adequately identify and assess the risks.
VAGO's 2008 guide Investing Smarter in Public Sector ICT: Turning principles into practice clearly describes the need to understand the role of business process restructuring and the agency's capability to execute an ICT investment before finalising a business case.
Figure 3I
Key stages in the RandL project
2009–10—business case and funding for initial design and procurement:
July 2010—contract signed for design, implementation and operation:
March to May 2011—design completed and project paused:
August 2011—DTF received consultant's review report:
November 2011—funding decision:
2012–13—remobilising the project and addressing the funding conditions:
2013–14—Events leading to the second project pause:
|
3.5.3 Underpinning evidence
RandL project complexity and challenges
RandL is an ICT project where VicRoads is responsible for replacing the multiple systems used for road vehicle and marine recreational vessel licensing and registration.
The current systems are old, difficult to use and expensive to maintain and modify, and they do not provide reliable data or adequate protection against fraud. They also constrain the government from making regulatory and policy changes and participating in national improvement initiatives. The Department of Transport, Planning and Local Infrastructure (DTPLI) advised that there have been system enhancements since 2011 to mitigate these issues and risks.
The term 'ICT' can be misleading because this type of project involves much more than specifying and purchasing new technology—it is a business transformation project where new technology and revised policies, practices and behaviours need to fit together if the project is to succeed.
Successfully delivering a project of this type and complexity requires capabilities and experience outside of VicRoads' core competencies around the planning, construction, maintenance and renewal of road-related infrastructure. Specifically, it requires:
- expertise in specifying and procuring ICT hardware and software from major ICT vendors and managing the design and implementation of these systems
- an understanding of current systems and practices and how to cost-effectively achieve intended outcomes through a combination of ICT investments and changes to policy, regulation and work practices
- a successful track record in integrating business needs and constraints in every aspect of project development and delivery, and a good understanding of the planning, consultation and training needed to do this successfully.
Overall finding—management and oversight gaps
Our examination of the evidence shows that VicRoads and DTF put in place the type of management and oversight structures and processes expected for a major government investment. These included:
- appointing an executive director and management team
- regular project reporting
- setting up a project board, with agency, DTF, Department of Premier and Cabinet, and independent representatives, as well as regular meetings to monitor progress
- DTF reviews of the 2009–10 business case and the equivalent of a HVHR review of the updated 2011 business case
- incorporating the project within the HVHR process from late 2011.
However, these structures and processes failed to adequately comprehend and control risks before they materialised to significantly delay completion and increase the estimated cost well beyond the approved project budget.
DTF independent review, September 2013
DTF commissioned a further review of the project, based on advice from VicRoads in June 2013 forecasting an 18 month delay in project delivery and an emerging, significant funding gap.
The September 2013 independent review confirmed the serious weaknesses in the project's management and oversight up to this point by concluding that:
- The approved budget and scope did not deliver a working solution because VicRoads estimated it needed $61 million more than the approved budget to cover the change requests, and this excluded a range of other cost risks.
- The project was not as advanced as the project team though it was. When testing, deployment and change requests were considered, the project was only 40percent complete, compared to the team's estimate that 85 per cent of the core solution had been built.
- The poor definition of the project scope had led to change requests as more detailed analysis uncovered new requirements. The project was set up to replace legacy systems and streamline processes, but did not have a mandate to transform business operations. Without this mandate, change requests to replicate current processes had all been viewed as 'critical'.
- There had been a lack of representation of VicRoads Information Management and Technology division within the governance structure, leading to a misalignment of the project to broader VicRoads strategies, limited expert scrutiny of contractors and limited consideration of the operational impacts of decisions and change requests.
- There had been significant shortfalls in the project's management since remobilisation, particularly around system design validation, vendor management and project financial oversight.
- There was a core skills gap with respect to vendor management and independent quality assurance.
- There had been a lack of focus on strategic risk management. Sufficiently detailed information on risks, finances and schedule had not been provided to the project board, including information about the risks of a single stage deployment strategy.
The review included recommendations that:
- VicRoads analyse staged deployment options because a single phase deployment is too risky
- VicRoads improve the clarity and transparency of the information provided to the project board about costs, risks, mitigations and vendor management issues
- VicRoads engage an appropriately experienced project director and source an enterprise architect to advise on the deployment options
- VicRoads, with the project board, revisit the project's governance regarding regular independent quality assurance reporting and the integration of VicRoads ICT functions and chief information officer into the project governance.
The September 2013 review contrasts with the August 2011 review, because the earlier review did not highlight issues with the team's capability, the design process or the choice of a single phase implementation.
3.5.4 Lessons from the RandL experience
The particular lessons from this project are not new but are worth reaffirming.
Major ICT projects need to be approached as business transformation projects, not as siloed technology upgrades.
This involves an end-to-end, holistic consideration of how to combine upgraded technology, revised legislation and policies and modified business processes to best meet the intended outcomes. The process must involve—from start to finish—all those connected to the changes, including partner agencies, employees and customers.
Doing this effectively requires people who can bring this set of skills to manage, oversee and independently quality-assure these types of projects. This should affect the appointment of project directors, the composition of project boards and the appointment of consultants to do independent reviews.
Ideally, each line of management and oversight should include people with a track record of delivering similar projects.
3.5.5 Current status of RandL
By the end of 2013 VicRoads had:
- strengthened the project team and board by appointing appropriately experienced personnel
- commissioned reviews to re-evaluate the project costs and risks and underpin these estimates for a more holistic approach to business transformation
- worked up phased development options to mitigate the risks of a single phase development and to secure major beneficial changes as soon as possible.
The DTPLI verified the options and estimated costs and time lines before submitting this material to government.
The project is currently paused for one year from February 2014 to allow VicRoads to update the business case to further explore the options for delivering the project and working with DTPLI to investigate the potential for legislative reform to streamline service delivery.
To the end of February 2014, a total of $102.4 million had been spent on RandL.
Recommendations
That the Department of Treasury and Finance:
- provides greater assurance that High Value High Risk reviews comprehensively test compliance with its Investment Lifecycle and High Value High Risk Guidelines in areas critical for project deliverability
- checks that for complex, risky projects—particularly those involving information and communications technology transformations—the specialist skills needed to successfully manage, oversee and quality assure these projects have been assessed and acquired.
Appendix A. Audit Act 1994 section 16—submissions and comments
Introduction
In accordance with section 16(3) of the Audit Act 1994, a copy of this report was provided to:
- Department of Treasury and Finance
- Department of Transport, Planning and Local Infrastructure
- Department of Health
- VicRoads
- Public Transport Victoria.
The submissions and comments provided are not subject to audit nor the evidentiary standards required to reach an audit conclusion. Responsibility for the accuracy, fairness and balance of those comments rests solely with the agency head.
Responses were received as follows:
- Department of Treasury and Finance
- Department of Transport, Planning and Local Infrastructure
- Department of Health
- VicRoads
- Public Transport Victoria
RESPONSE provided by the Secretary, Department of Treasury and Finance
RESPONSE provided by the Secretary, Department of Transport, Planning and Local Infrastructure
RESPONSE provided by the Secretary, Department of Health
RESPONSE provided by the Chief Executive, VicRoads
RESPONSE provided by the Chief Executive Officer, Public Transport Victoria
